Clinical OperationsPharmaCROClinical Operations

Study Start-Up Cycle Time: Where the Weeks Actually Go

8 min read
The path from site selection through contracting and regulatory submission to first patient in

Study start-up rarely slips on one large delay. It slips on six serial steps, each individually reasonable, with waiting time between them that nobody owns. Two of the common step pairs have no real dependency at all, which is where the recoverable weeks are.

Activation timelines get discussed as a single number, which hides the structure underneath. A study that takes fourteen weeks from site selection to first patient in did not spend fourteen weeks working. It spent a few weeks working and the rest waiting, in places that a timeline report does not distinguish.

This guide walks the six steps, separates work from waiting, and identifies which sequencing is a genuine dependency and which is habit. It sits under which system owns which part of the study.

After reading this you will be able to:

  • Break an activation timeline into milestones rather than one number
  • Separate the weeks spent working from the weeks spent waiting
  • Identify which step pairs can run in parallel without adding risk
  • Plan submissions backward from committee dates instead of forward from readiness

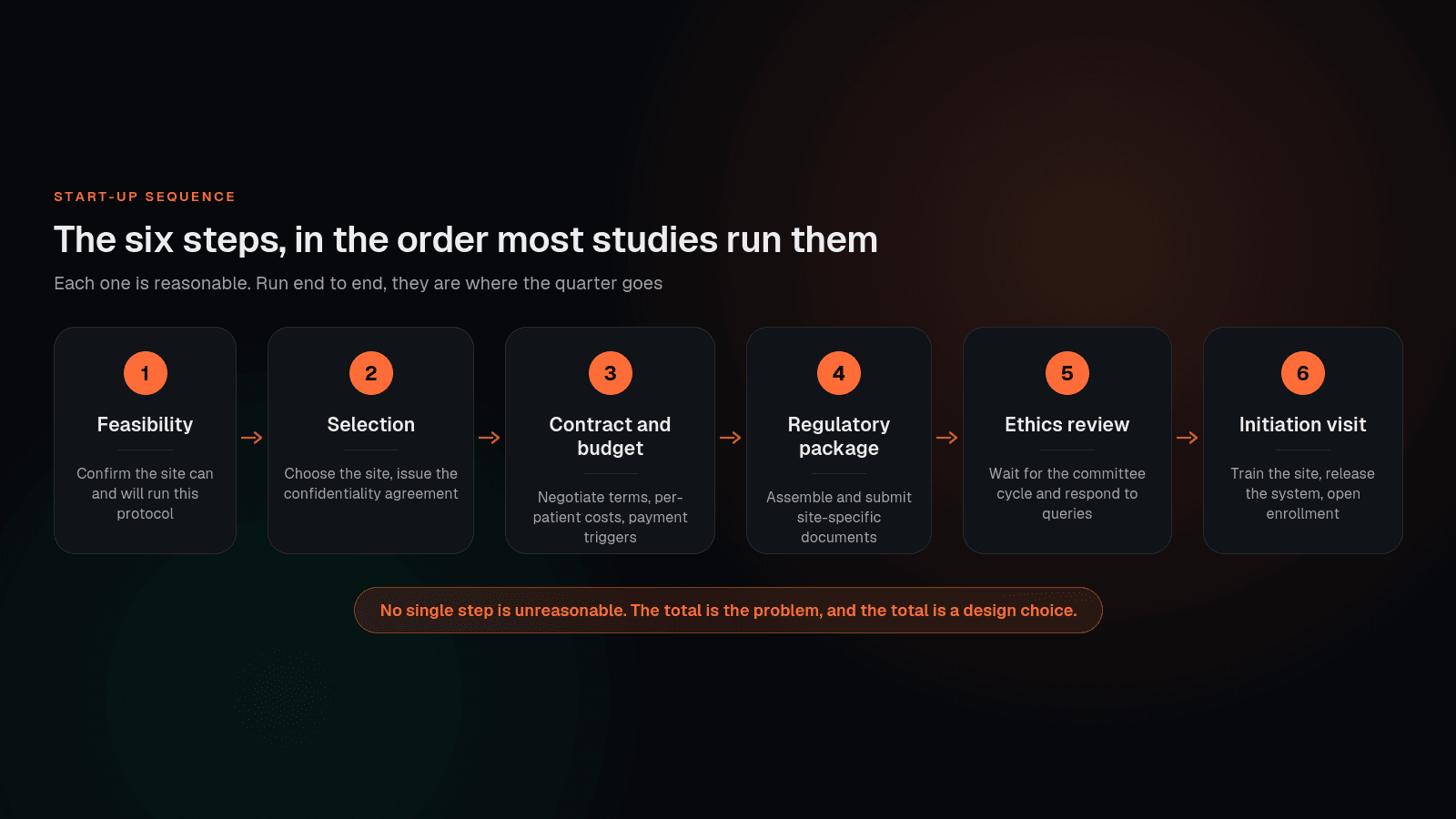

The Six Steps

The six steps of study start-up shown in the order they usually run, from feasibility to site initiation
The six steps in the order most studies run them.

Read that sequence and nothing looks wrong. Each step has a clear purpose, a clear owner and a defensible duration. The problem is not any single step, it is that they are arranged end to end when several of them do not need to be.

It is also worth noticing which step the clock is usually measured from. Teams that start counting at site selection get a very different number from teams that start at feasibility, and comparing across organizations without checking that definition produces benchmarks that mean nothing.

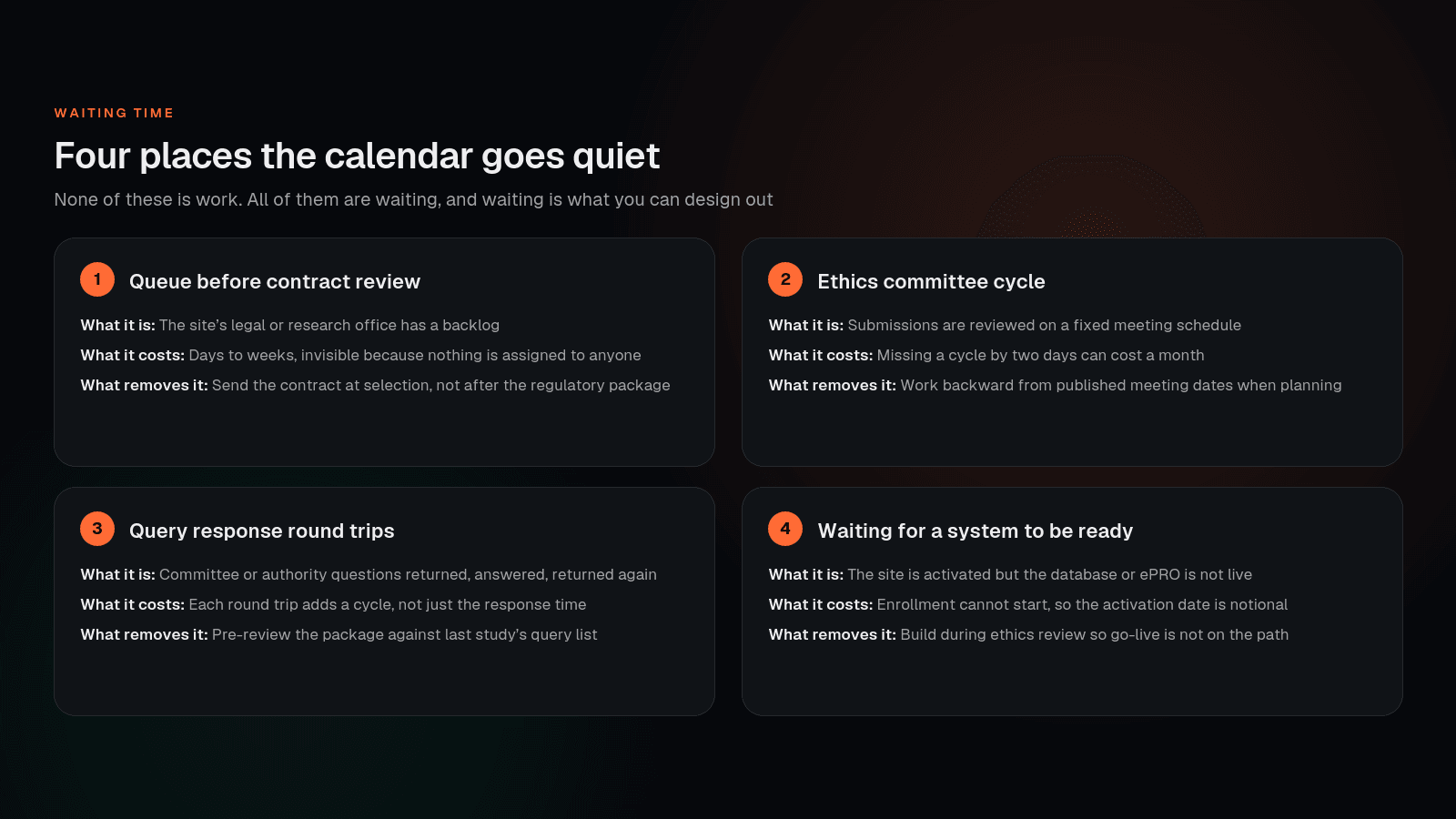

Where the Calendar Goes Quiet

Four sources of waiting time in study start-up, each with who is waiting on whom and what removes the wait
Four sources of waiting, and what removes each one.

The first is the one worth attacking first, because it is pure sequencing. A contract sent at site selection enters the research office queue while the regulatory package is still being assembled. A contract sent after the package is ready enters the same queue, several weeks later, having gained nothing.

The fourth is the one most often missed in reporting, because the site shows as activated and the milestone is met. If the database or the ePRO is not live, the activation date is notional and enrollment cannot start. That gap is invisible in a CTMS milestone report unless someone deliberately tracks system readiness as its own date.

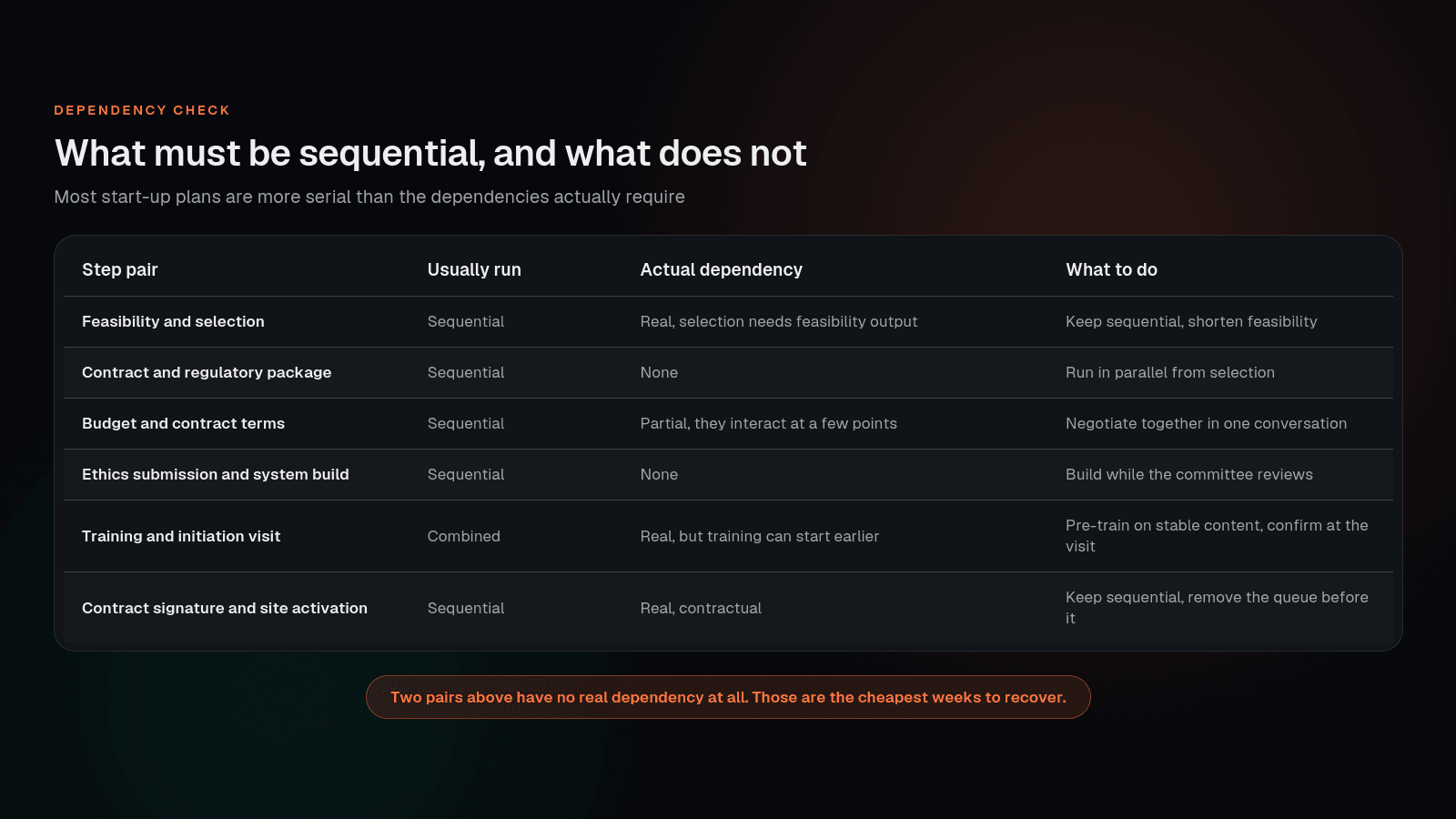

What Can Actually Run in Parallel

Which study start-up steps must stay sequential and which can be run in parallel to compress the timeline
Which pairs have a real dependency and which do not.

Two rows have no dependency whatsoever. Contract negotiation does not require the regulatory package, and the database build does not require ethics approval. Both are routinely run sequentially because the plan was drawn that way, not because anything breaks if they overlap.

Building the database during ethics review is the larger of the two, and it connects directly to the data management timeline. The build sequence itself, and the steps within it that get compressed under pressure, are covered in every step between final protocol and first patient in.

The Contract Step, Honestly

Contract and budget is reliably the longest single step, and the usual explanation is that negotiation is slow. That is mostly not what is happening.

The negotiation itself is often two or three working sessions. The elapsed time comes from three things: the gap before the site’s office picks the document up, budget and terms being handled as separate threads that alternate, and per-patient cost discussions that reopen once the visit schedule is properly understood.

All three are addressable. Send at selection. Put budget and terms in one conversation with both decision-makers present. And make sure the visit schedule and its payment triggers are settled before the budget is drafted, because reopening cost after the fact is what produces the second round. How those triggers should be wired is covered in why the CTMS and the finance system disagree.

Measuring It So the Answer Is Actionable

One activation number tells you whether you have a problem. It does not tell you where.

Track elapsed days between named milestones instead: selected to contract sent, sent to executed, package ready to submitted, submitted to approved, approved to initiated, initiated to first patient in. Use the median rather than the mean, because a single outlier site will otherwise hide a consistent pattern across the rest.

Then segment by site type. Academic centers, hospital networks and private sites have genuinely different queue behavior, and a plan built on a blended average will be wrong for all three. Feasibility and selection decisions that account for that are covered by site identification and feasibility tooling, and the same pattern applied with AI is worked through in the site selection and feasibility use case.

Three Changes Worth Making First

  1. Send the contract at site selection, before the regulatory package is assembled.
  2. Start the database build during ethics review rather than after approval.
  3. Plan the submission date backward from published committee meeting dates.

None of these requires new tooling or additional headcount, and together they typically account for most of the recoverable time. Clinera CTMS tracks the milestone dates that make the effect measurable rather than anecdotal.

References

  • ICH E6(R3) Good Clinical Practice, trial conduct and site management. International Council for Harmonisation, adopted 6 January 2025. www.ich.org
  • 21 CFR Part 312, Investigational New Drug Application. US Code of Federal Regulations, Title 21, Part 312. www.ecfr.gov
  • Clinical Trials Regulation EU No 536/2014. European Medicines Agency, clinical trials regulation. health.ec.europa.eu

This guide describes process and regulatory expectations in general terms and is not legal or regulatory advice. Confirm the current version and applicability of any standard or guidance for your study and region.
